Document Control
Document Information
Project Title |
Contract No. SPW 07/2020 Environmental Team for Construction of Yuen Long Effluent Polishing Plant Stage 1 |
Document Title |
Pre-construction Survey Report of Ardeid Night Roost |
Fugro Project No. |
0120/20 |
Fugro Document No. |
0120/20/ED/0281e |
Issue Number |
05 |
Issue Status |
Final |
Fugro Legal Entity |
Fugro Technical Services Limited |
Issuing Office Address |
A Room 723 & 725, 7/F, Block B, Profit Industrial Building, 1-15 Kwai Fung Crescent, Kwai Chung, Hong Kong |
Client Information
Client |
Drainage Services Department |
Client Address |
45/F, Revenue Tower, 5 Gloucester Road, Wan Chai, Hong Kong |
Client Contact |
Mr. LAM Yu Wang |
Document History
Issue |
Date |
Status |
Comments on Content |
Prepared By |
Checked By |
Approved By |
01 |
28 Jan 2021 |
For review |
Awaiting client and IEC comments |
KJB |
FN |
YO |
02 |
17 Feb 2021 |
For review |
Addressed IEC 05 Feb comments |
KJB |
FN |
YO |
03 |
15 Mar 2021 |
For review |
Addressed AFCD 12 Mar comments |
KJB |
FN |
YO |
04 |
16 Mar 2021 |
For review |
Addressed AFCD 16 Mar comments |
KJB |
FN |
YO |
05 |
24 Mar 2021 |
For review |
Addressed EPD 23 Mar comments |
KJB |
FN |
YO |
06 |
29 Mar 2021 |
Approved |
No further comment from AFCD |
KJB |
FN |
YO |
Project Team
Initials |
Name |
Role |
YO |
David Y.O. Hung |
Environmental Team Leader |
FN |
Fenelyn Nabuab |
Ecologist |
KJB |
Kalvin Jay Boregon |
Assistant Ecologist |
RL |
Ray Li |
Assistant Environmental Consultant |
Fugro Technical Services Limited (FTS) has been appointed as the Environmental Team (ET) by Drainage Services Department (DSD) under Contract No. SPW 07/2020 Environmental Team for Construction of Yuen Long Effluent Polishing Plant Stage 1. As the ET, part of the scope, is to carry out a pre-construction survey for ardeid night roost in accordance with the requirements of EP Condition 2.11 and Section 7.3.5 of the approved EM&A Manual of the Yuen Long Effluent Polishing Plant (“the Project”).
Pre-construction surveys for ardeid roosts were conducted on January 2021, where initial survey was carried out on 12 January and confirmatory survey on 25 January. The surveys were undertaken in areas within 100 m from the Project boundary (“the Survey Area”).
Two active night roost areas were observed within the Survey Area during the surveys, i.e. one at the mangrove strip located east of the Project boundary and the other at the northeast side of the Project boundary. Four ardeid species including the Chinese Pond Heron Ardeola bacchus, Great Egret Ardea alba, Little Egret Egretta garzetta, and Grey Heron Ardea cinerea were observed utilizing the roosting sites. The roosting substrates were the mangrove species Sonneratia apetala and S. caseolaris. For the Pre-roosting aggregation (PRA), only one species, the Chinese Pond Heron was observed with the behaviour which started as early as 17:38, while during this time, final roosting activities for other ardeid species were concurrently noted already. No breeding activity was noted in both roosting areas as the breeding season of the ardeids have not begun yet.
Based on the findings of the surveys, it is recommended that use of powered mechanical equipment within 100 m buffer zone from the active night roosting sites after 17:30 during dry season will be restricted. Time restrictions during wet season (after 18:00) shall follow Section 7.3.11 of the approved EM&A Manual. Noise monitoring in stations as close as practicable to the active night roosts will be conducted concurrent with the construction phase monthly monitoring of the active night roosts.
Contents
1.2 Scope and Objectives of the Survey
4.1 Recommended Noise Monitoring Activities
4.1.1 Monitoring Locations, Frequency, Time and Parameters
4.1.2 Proposed Action Level and Limit Level and Corresponding Responses in case/s of exceedance/s
4.2 Recommended Measures to Minimize Impact on the Ardeid Night Roosts during Project Construction
4.2.1 Recommended Measure to Minimize Noise Impact
4.2.2 Recommended Measure to Minimize Light Overspill
Tables in the Main Text
Table 3.1: Initial Survey Findings
Table 3.2: Confirmatory Survey Findings
Table 4.1: Noise Monitoring Parameters
Table 4.2: Action Level and Limit Level
Table 4.3: Event and Action Plan
Table 4.4: Noise Monitoring Equipment Specifications
Appendices
Abbreviations
DSD |
Drainage Services Department |
EIA |
Environmental Impact Assessment |
EIAO |
Environmental Impact Assessment Ordinance |
EM&A |
Environmental Monitoring and Audit |
EPD |
Environmental Protection Department |
EP |
Environmental Permit |
ET |
Environmental Team |
FTS |
Fugro Technical Services Limited |
HKO |
Hong Kong Observatory |
PRA |
Pre-roost Aggregate |
PRP |
Pre-roost Period |
YLEPP |
Yuen Long Effluent Polishing Plant |
As described in Section 8.5.2.7 of the EIA Report, ardeid species of conservation importance (i.e. Little Egret, Great Egret, and Chinese Pond Heron) were observed roosting at night in the mangrove habitat northeast to the Project site during night-time surveys in June 2017 (Appendix A.1). The ardeid night roost observed, was not however, found during night-time surveys in July 2017. Further site checks in July 2018 showed that ardeids utilized again the mangrove habitat northeast to the Project site. Ardeids (over 60 individuals) were also observed roosting at the mangrove strip east of the Project site (Appendix A.1) in December 2018 but the ardeid night roost northeast to the Project site was not observed during the site visits.
In connection to this, the survey conducted with reference to EP Condition 2.11 and Section 7.3.5 of the EM&A Manual had the following objectives:
· Confirm the location (s) and status of any active ardeid night roost (s) within 100 m of the Project site boundary with reference to EP Condition 2.11 and Section 7.3.5 of the EM&A Manual; and
· Subject to survey findings, suggest a location as close to the night roost as practicable for monitoring of noise level during construction Section 7.3.5 of the EM&A Manual.
· Section 2 details the methodology of the Survey;
· Section 3 details the Survey results;
· Section 4 presents the summary, conclusion, and recommendations based on the Survey results.
This section presents the methodology and approach of the Survey during the pre-construction stage of the Project. The Survey was conducted in accordance with the Method Statement that was agreed upon with the Agriculture, Fisheries and Conservation Department prior to the commencement of the Survey.
With reference from EP Condition 2.11 and Section 7.3.5 of the EM&A Manual, the Survey was conducted in areas within 100 m from the Project boundary (“the Survey Area”). The Survey Area and vantage points for direct observation of any active night roosts are shown in Appendix A.1.

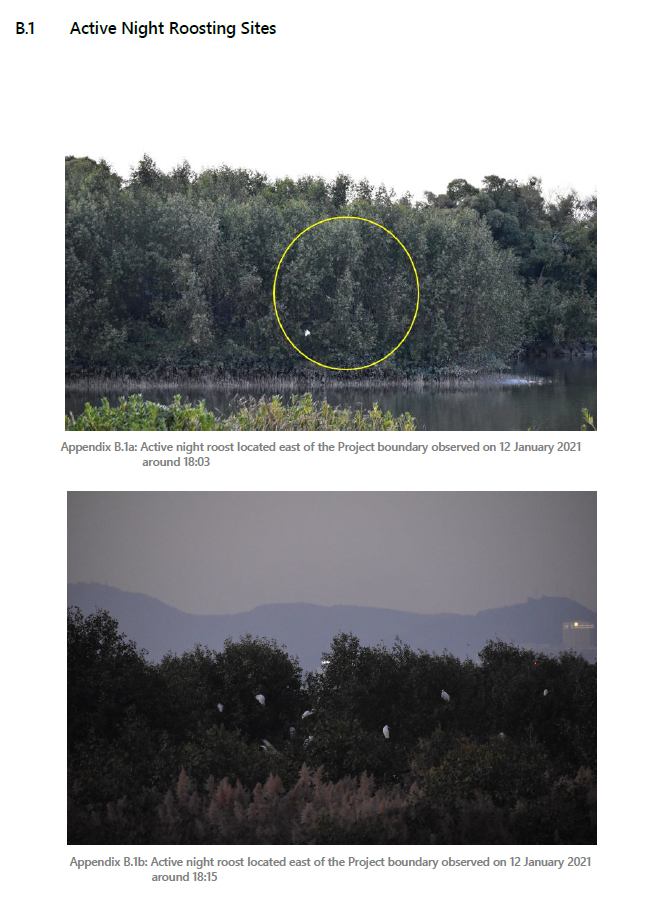

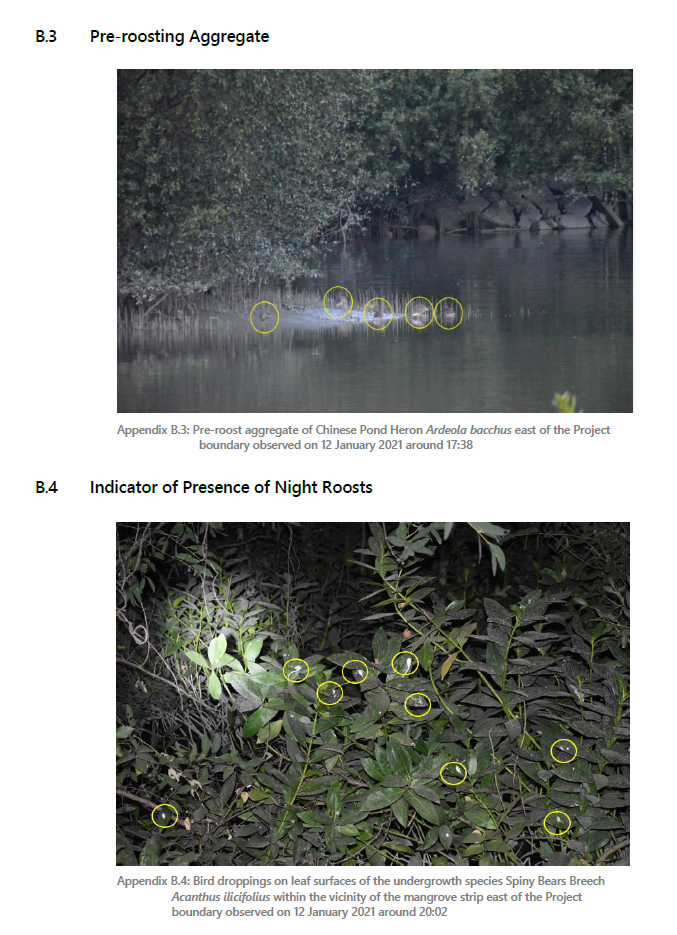

Two active night roosts (NR) locations were observed within the Survey Area, 100 m study from the Project boundary (Appendix A.1). One NR was confirmed to be still present on the EIA pre-identified mangrove strip located approximately 40 m east of the Project boundary (Appendix B.1a) and a new NR several meters away from the pre-identified one and approximately 45 m northeast (Appendix B.1b.) of the Project boundary along the Shan Pui River.
A total of four ardeid species, i.e. Chinese Pond Heron Ardeola bacchus, Great Egret Ardea alba, Little Egret Egretta garzetta and Grey Heron Ardea cinerea, was observed utilizing the aforementioned roosting sites.

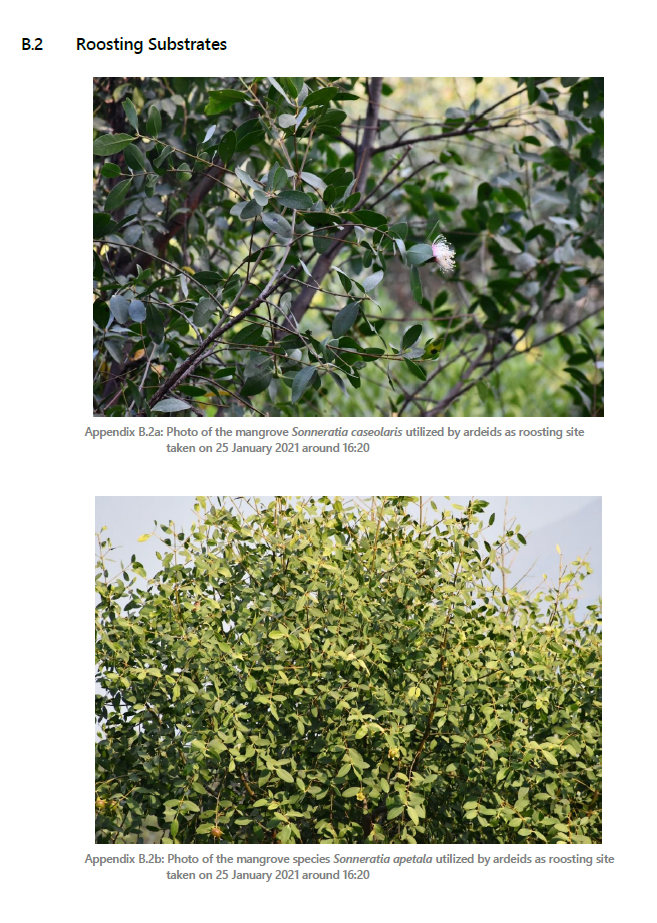

The mangrove species Sonneratia apetala (Appendix B.2a) and S. caseolaris (Appendix B.2b) were utilized as roosting substrates. Both Sonneratia species located east of the Project boundary had an approximate height of five meters while same species were of an approximate height of 3 to 4 meters on the northeast of the Project boundary.
During the pre-roost period (PRP), the period when avian individuals gather first before flying into a night roost, in this case at around 17:38 of the survey, only PRA of the Chinese Pond Heron (Appendix B.3) with five individuals (ind.) was observed. The aggregate was noted on the exposed mudflat contiguous to their final roosting substrate the mangrove species S. apetala and S. caseolaris. The mudflat was exposed due to the low tide condition during that period. No PRAs of other ardeid species was recorded.
For the final night roost, different times were observed for the different species such that it started as early as around 17:38 onwards for the Great Egret and Little Egret; while a little later at around 18:03 for the Chinese Pond Heron. A total of 20 Great Egret individuals were observed utilizing the emergent to canopy layers of the aforementioned mangrove species at the roosting site northeast of the Project boundary while another 20 ind. of the Little Egret which arrived in flock also utilized the canopy to emergent layers of these roosting substrate, at the same site, for their final roost. On the other hand, at around 18:03, eight ind. of the Chinese Pond Heron were observed at the roosting site east of the Project boundary. These were roosting on the inner portion of the understory layer of the roosting substrate. Bird droppings were noted within the vicinity (Appendix B.4).
Summary of results is presented in Table 3.1.
During the PRP, the period with reference to the initial survey results, no PRA of the Chinese Pond Heron nor of any other ardeid species was observed within the survey area.
For the final night roost, unlike the results of the initial survey, all the four ardeid species (i.e. Chinese Pond Heron, Grey Heron, Great Egret and Little Egret) were observed to arrive at their respective final roost sites at around 18:15. A total of three ind. of Chinese Pond Heron and one ind. of Grey Heron were noted at the roosting site east of the Project boundary. Similar with the initial survey results, individuals of Chinese Pond Heron were still observed roosting on the inner portion of the understory layer of the roosting substrate. Meanwhile, the solitary Grey Heron was observed roosting at the exposed branch of the substrate’s understory layer. Bird droppings were noted within the vicinity. On the other hand, several ardeid species including Great Egret (seven ind.), Little Egret (12 ind.), Chinese Pond Heron (10 ind.) and Grey Heron (1 ind.) were noted roosting at the mangrove strip northeast of the Project boundary. Similar with initial survey results, individuals of Great Egret and Little Egret were observed utilizing the emergent to canopy layers of the roosting substrate; while the Chinese Pond Heron individuals utilized the inner understory portion of the substrate and Grey Heron used the outer portion of the understory layer.
Summary of results is presented in Table 3.2.
Table 3.1: Initial Survey Findings
Date: 12 January 2021 Tidal Condition: Low Tide |
|||||||
Pre-roost Period |
Final roost Period |
||||||
Time of Return: |
17:38 (Chinese Pond Heron) |
Time of Return: |
17:38 (Great Egret and Little Egret); 18:03 (Chinese Pond Heron) |
||||
Parameters |
Location |
Parameters |
Location |
||||
ANR1 |
ANR2 |
ANR1 |
ANR2 |
||||
Pre-roost Aggregation (Y/N): |
Y |
N |
Substrate Species: |
Sonneratia apetala and S. caseolaris |
Sonneratia apetala and S. caseolaris |
||
Substrate Species: |
Sonneratia apetala and S. caseolaris |
Sonneratia apetala and S. caseolaris |
Substrate Height (m): |
Approximately 5 m. |
Approximately 3-4 m. |
||
Substrate Height (m): |
Approximately 5 m. |
Approximately 3-4 m. |
|||||
Ardeid Species Composition |
Abundance (individuals) |
Ardeid Species Composition |
Abundance (individuals) |
||||
ANR1 |
ANR2 |
ANR1 |
ANR2 |
||||
Chinese Pond Heron Ardeola bacchus |
5* |
- |
Chinese Pond Heron Ardeola bacchus |
8 |
- |
||
|
|
|
Great Egret Ardea alba |
- |
20 |
||
|
|
|
Little Egret Egretta garzetta |
- |
20 |
||
Breeding Activity (Y/N): |
ANR1 |
N |
|||||
ANR2 |
N |
||||||
Notes: Pre-roost Period: Period when avian individuals gather first before flying into a night roost ANR1: Active ardeid night roost area east of the Project boundary ANR2: Active ardeid night roost area northeast of the Project boundary *: individuals aggregated on the exposed mudflat contiguous to their final mangrove roosting substrate -: not recorded |
|||||||
Table 3.2: Confirmatory Survey Findings
Date: 25 January 2021 Tidal Condition: High Tide |
|||||||
Pre-roost Period |
Final roost Period |
||||||
Time of Return: |
- |
Time of Return: |
18:15 |
||||
Parameters |
Location |
Parameters |
Location |
||||
ANR1 |
ANR2 |
ANR1 |
ANR2 |
||||
Pre-roost Aggregation (Y/N): |
N |
N |
Substrate Species: |
Sonneratia apetala and S. caseolaris |
Sonneratia apetala and S. caseolaris |
||
Substrate Species: |
Sonneratia apetala and S. caseolaris |
Sonneratia apetala and S. caseolaris |
Substrate Height (m): |
Approximately 5 m. |
Approximately 3-4 m. |
||
Substrate Height (m): |
Approximately 5 m. |
Approximately 3-4 m. |
|||||
Ardeid Species Composition |
Abundance (individuals) |
Ardeid Species Composition |
Abundance (individuals) |
||||
ANR1 |
ANR2 |
ANR1 |
ANR2 |
||||
- |
- |
- |
Chinese Pond Heron Ardeola bacchus |
3 |
10 |
||
|
|
|
Grey Heron Ardea cinerea |
1 |
1 |
||
|
|
|
Great Egret Ardea alba |
|
7 |
||
|
|
|
Little Egret Egretta garzetta |
|
12 |
||
Breeding Activity (Y/N): |
ANR1 |
N |
|||||
ANR2 |
N |
||||||
Notes: Pre-roost Period: Period when avian individuals gather first before flying into a night roost ANR1: Active ardeid night roost area east of the Project boundary ANR2: Active ardeid night roost area northeast of the Project boundary *: individuals aggregated on the exposed mudflat contiguous to their final mangrove roosting substrate -: not recorded |
|||||||
Two active night roost sites were observed within the Survey Area, 100 m from the Project boundary. One site was located in the mangrove strip east of the Project boundary and the other in the northeast portion of the Project boundary. Four ardeid species including the Chinese Pond Heron, Great Egret, Little Egret and Grey Heron were observed utilizing the aforementioned roosting sites. The mangrove species S. apetala and S. caseolaris were utilized as roosting substrate. For the Pre-roosting aggregation (PRA), only one species, the Chinese Pond Heron was observed with the behaviour which started as early as 17:38, while during this time, final roosting activities for other ardeid species were concurrently noted already. No breeding activity was noted in both roosting areas as the breeding season of the ardeids have not begun yet.
According to the findings of the current survey, it is suggested that use of powered mechanical equipment within 100 m buffer zone from the active night roosting sites after 17:30 during dry season will be restricted. Time restrictions during wet season (after 18:00) shall follow Section 7.3.11 of the approved EM&A Manual. The relevant buffer zone is shown in Appendix A.1. The night roosts pre-identified in the EIA report were also considered in determining the maximum buffer zones to account for the dynamic roosting activities within the vicinity. Furthermore, noise monitoring will be conducted in stations (NMS1 and NMS2) (Appendix A.1) as close as practicable to these night roosts during the construction phase of the Project.

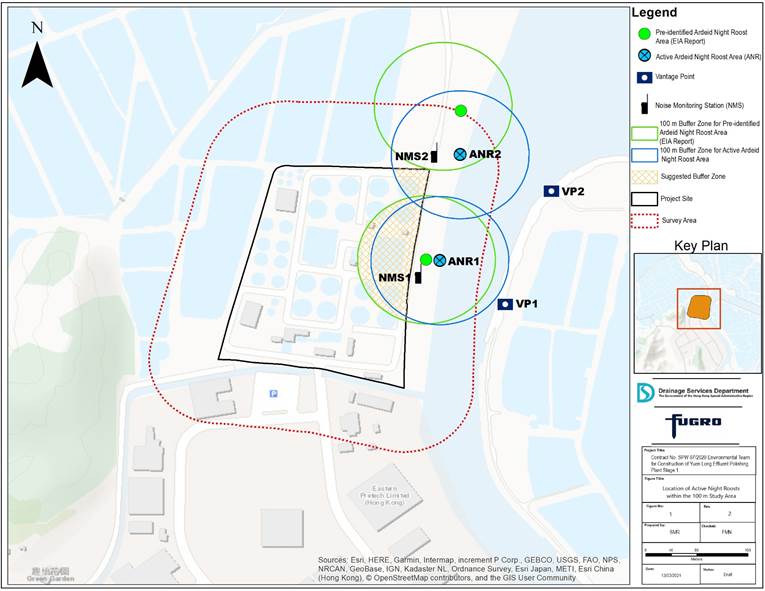

The recommended noise monitoring locations shall be established at 22°28’4.25”N, 114°1’41.32”E; and 22°28’10.43”N, 114°1’42.17”E for NMS1 and NMS2 stations, respectively. Monitoring frequency shall be once a month in concurrence with the construction phase monthly monitoring of the active night roosts for correlation. Monitoring time for both stations shall start around 17:38, the earliest pre-roost period recorded during the survey, and shall last for 30 minutes. Table 4.1 presents the monitoring parameters.
Table 4.1: Noise Monitoring Parameters
Parameter |
Frequency and Period |
LAeq (30 min) (L10 and L90 will be recorded for reference) |
Monthly in concurrence with the construction phase monthly monitoring of the active night roosts |
As there are no specific guidelines on noise thresholds for roosting egrets, the Action and limit specified in Table 4.2 were based on study conducted on exploring behavioural responses of shorebirds to impulsive noise (Wright et al. 2010).
Table 4.2: Action Level and Limit Level
Time Period |
Action Level |
Limit Level |
after 17:30 during dry season after 18:00 during wet season |
65.5 dB(A)1 |
72.2 dB(A)2 |
Notes: 1. behavioural response of some kind more likely to occur 2. flight with abandonment of the site becomes the most likely outcome of the disturbance |
Exceedances to the limit level shall be prevented by the full implementation of mitigation measures (Section 4.2 of this report) during the construction phase.
In instances of exceedance/s in the proposed action and/or limit levels, the different measures as specified in Table 3.3 Event and Action Plan for Construction Noise of the approved EM&A Manual and presented in Table 4.3 of this report shall be implemented as responses.
Table 4.3: Event and Action Plan
Event |
Action |
|||
ET |
IEC |
ER |
Contractor |
|
Action Level |
1. Notify IEC and Contractor; 2. Carry out investigation; 3. Report the results of investigation to the IEC, ER and Contractor; 4. Discuss with the Contractor and formulate remedial measures; and 5. Increase monitoring frequency to check mitigation effectiveness. |
1. Review the analyzed results submitted by the ET; 2. Review the proposed remedial measures by the Contractor and advise the ER accordingly; and 3. Supervise the implementation of remedial measures. |
1. Confirm receipt of notification of failure in writing; 2. Notify Contractor; 3. Require Contractor to propose remedial measures for the analyzed noise problem; and 4. Ensure remedial measures are properly implemented. |
1. Submit noise mitigation proposals to IEC; and 2. Implement noise mitigation proposals. |
Limit Level |
1. Identify source; 2. Inform IEC, ER, EPD and Contractor; 3. Repeat measurements to confirm findings; 4. Increase monitoring frequency; 5. Carry out analysis of Contractor’s working procedures to determine possible mitigation to be implemented; 6. Inform IEC, ER and EPD the causes and actions taken for the exceedances; 7. Assess effectiveness of Contractor’s remedial actions and keep IEC, EPD and ER informed of the results; and 8. If exceedance stops, cease additional monitoring. |
1. Discuss amongst ER, ET, and Contractor on the potential remedial actions; 2.Review Contractor’s remedial actions whenever necessary to assure their effectiveness and advise the ER accordingly; and 3. Supervise the implementation of remedial measures. |
1. Confirm receipt of notification of failure in writing; 2. Notify Contractor; 3. Require Contractor to propose remedial measures for the analysed noise problem; 4. Ensure remedial measures are properly implemented; and 5. If exceedance continues, consider what portion of the work is responsible and instruct the Contractor to stop that portion of work until the exceedance is abated. |
1. Take immediate action to avoid further exceedance; 2. Submit proposals for remedial actions to IEC within 3 working days of notification; 3. Implement the agreed proposals; 4. Resubmit proposals if problem still not under control; and 5. Stop the relevant portion of works as determined by the ER until the exceedance is abated. |
With reference to the requirements of the Technical Memorandum (TM) issued under the NCO, the sound level meters for the monitoring activities shall be in compliance with the International Electrotechnical Commission Publications 651: 1979 (Type 1) and 804: 1985 (Type 1) specifications. Immediately prior to and following each noise measurement, the accuracy of the sound level meter shall be checked using an acoustic calibrator generating a known sound pressure level at a known frequency. The measurements may be accepted as valid only if the difference between calibration levels obtained before and after the noise measurement is less than 1.0 dB. The equipment specifications are presented in Table 4.4.
Table 4.4: Noise Monitoring Equipment Specifications
Item |
Brand |
Model |
Equipment |
1 |
Casella |
CEL-63X Series |
Integrating Sound Level Meter |
2 |
Casella |
CEL-120/1 |
Calibrator |
3 |
Benetech |
GM816 |
Wind Speed Anemometer |

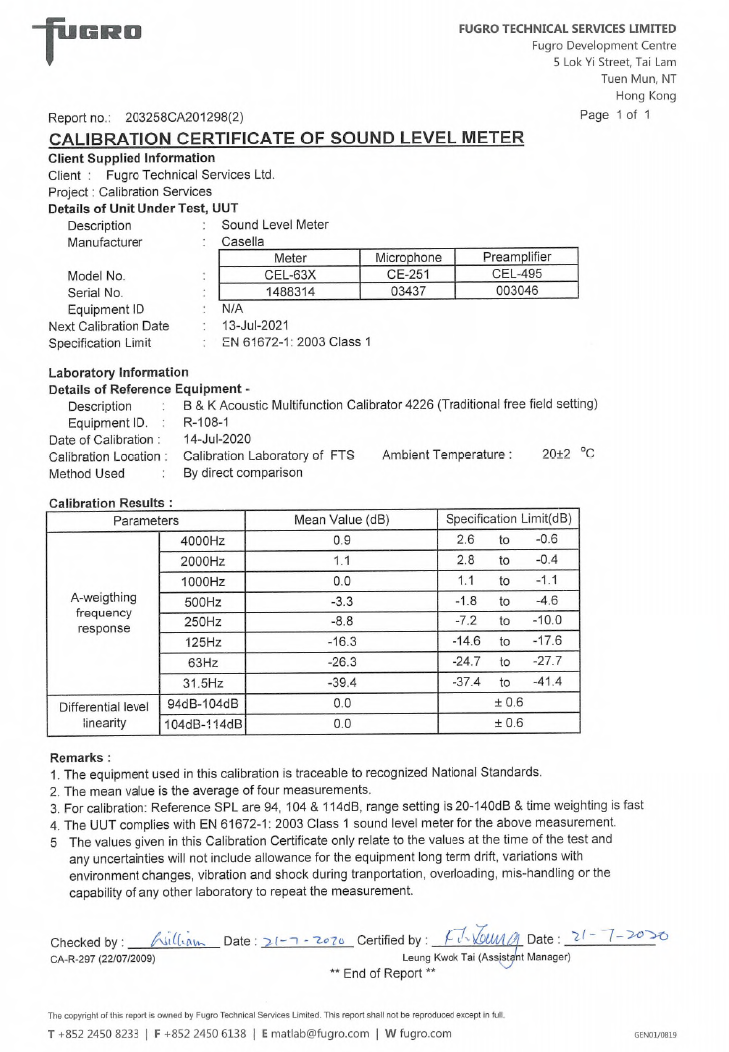

The catalogue of the noise monitoring equipment is presented in Appendix C.1.

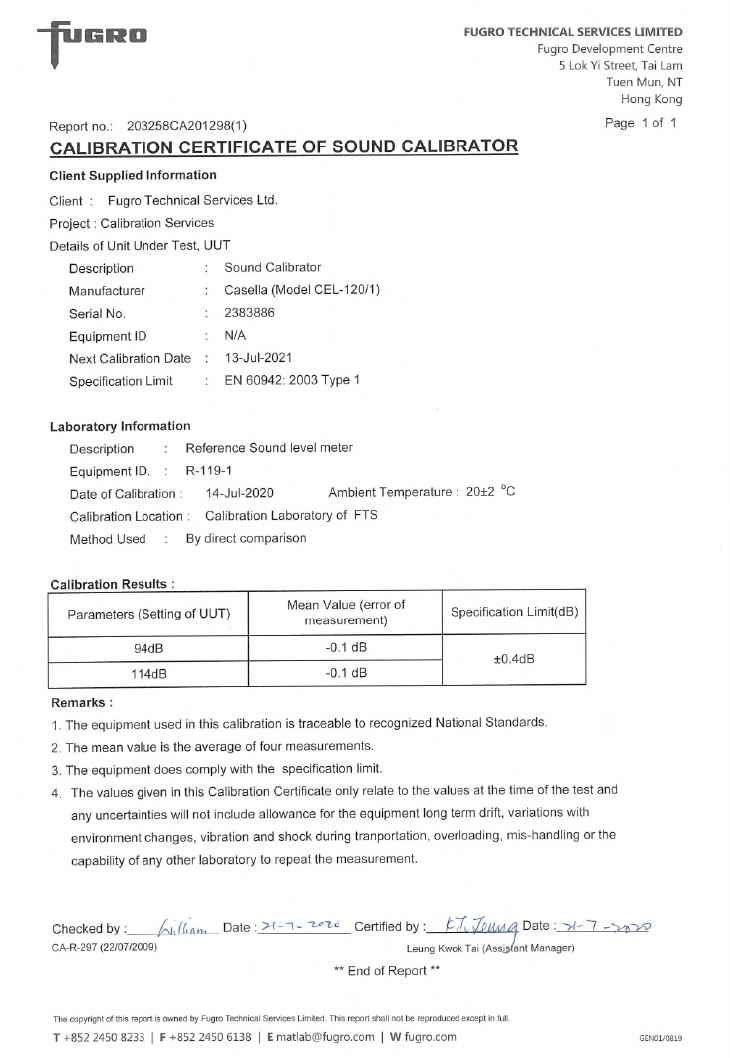

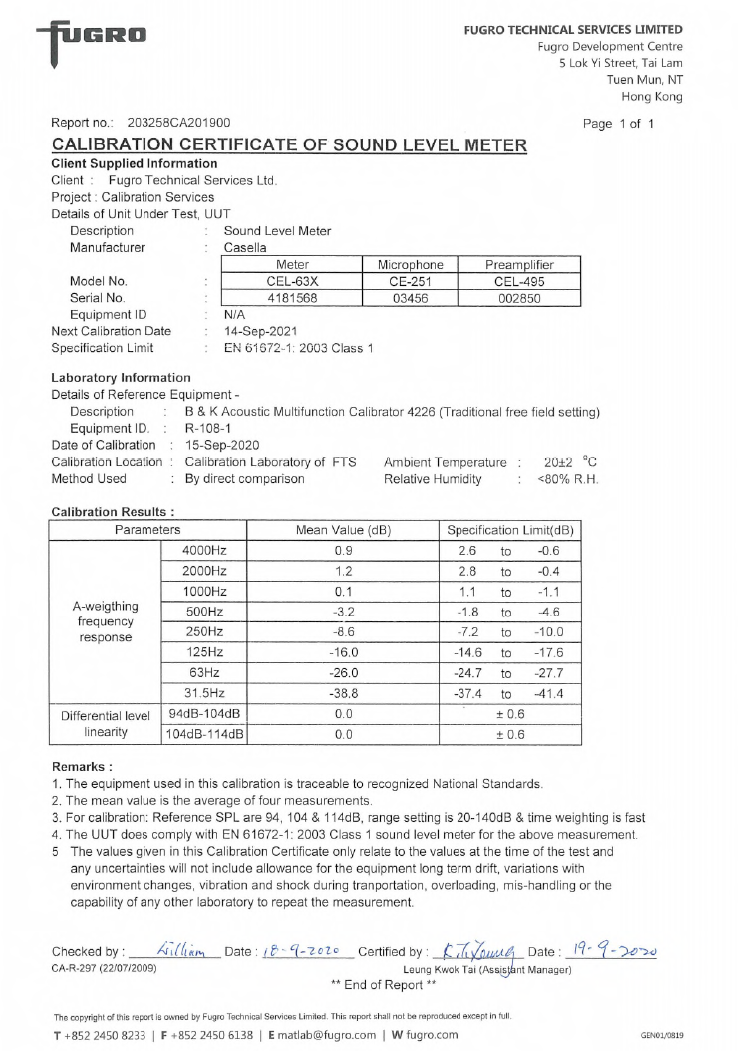

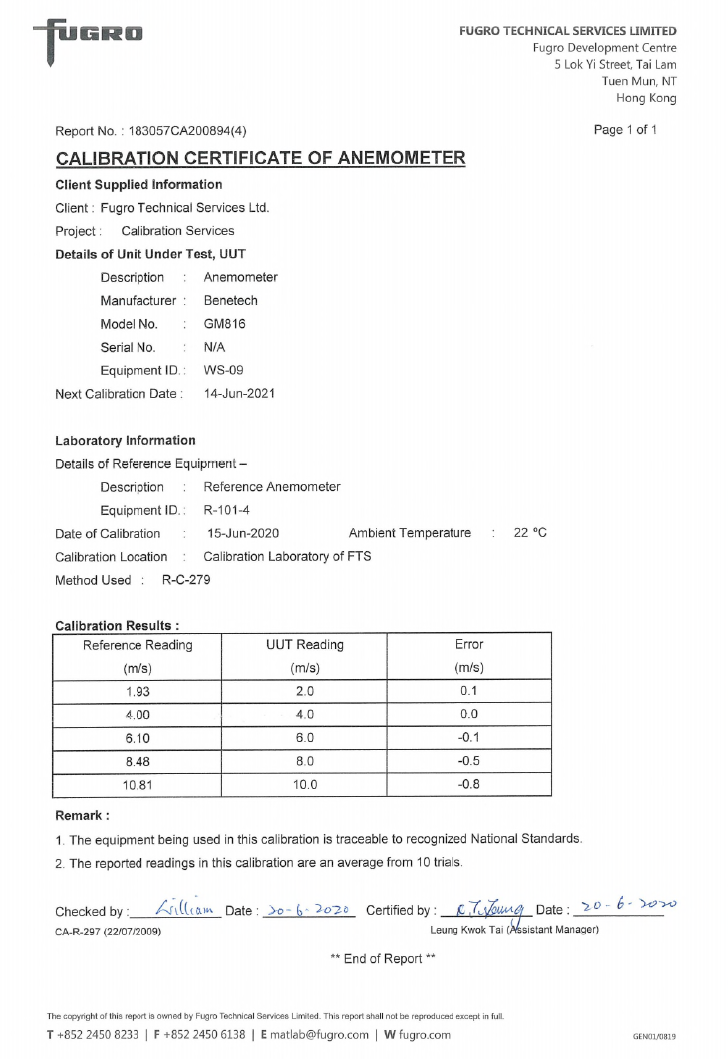

Current calibration certificates are presented in Appendix C.2.
· The battery condition shall be checked to ensure good functioning of the meter.
· Parameters such as frequency weighting, the time weighting and the measurement time shall be set as follows:
o frequency weighting: A
o time weighting: Fast
o measurement time: continuous 5 minutes interval
· Prior to and after noise measurement, each meter shall be calibrated using the calibrator for 94.0 dB at 1000 Hz. If the difference in the calibration level before and after measurement is more than 1.0 dB, the measurement shall be considered invalid and repeat of noise measurement is required after re-calibration or repair of the equipment.
· Noise measurements shall not be made in fog, rain, wind with a steady speed exceeding 5 m/s or wind with gusts exceeding 10 m/s. The wind speed shall be checked with a portable wind speed meter capable of measuring the wind speed in m/s.
Restriction on the use of powered mechanical equipment within 100 m buffer zone from the active night roosting sites after 17:30 during dry season and after 18:00 during wet season throughout the construction phase of the Project as described in Section 7.3.11 of the approved EM&A Manual. For additional protection of the nearby night roosts, noise barriers with absorptive materials of at least 4m high shall be erected along the periphery of the Project Site including at its northern and eastern sides as required by EP Condition 2.10 (iii) where the night roosts are located. Moreover, noise mitigation measures as mentioned in Section 3.8 of the approved EM&A Manual shall be strictly implemented.
However, in instances when night-time works will be inevitable, in addition to provision of noise barriers, measures such as use of low-noise technology and equipment; acoustic mats and enclosures as specified in the Noise Mitigation Measures Plan shall also be fully implemented as required by EP Condition 2.12 to minimize construction noise impacts on nearby night roosts.
There shall be no construction works with PME within 100m from the night roost after 18:00 during wet season and after 17:30 during dry season as described in Section 7.3.11 of the approved EM&A Manual to prevent light glare from the construction site to the nearby night roosts.
However, in instances when night-time works will be inevitable, directional down lighting and control of lighting periods and intensity shall be implemented as required by EP Condition 2.13 to minimize overspill of light to the roosting areas. All measures as recommended in the Proposal for Minimization of Overspill Light to Ecological Sensitive Area shall be fully implemented. No light glare shall illuminate towards the night roost areas and this shall be accomplished through preservation of Ficus microcarpa trees located at the Site boundary that shall act as barrier for light flow to the night roosts; and the establishment of noise barriers to also act as light barrier to roosting areas.
Moore, J.E. and P.V. Switzer. 1997. Pre-roosting aggregations in the American crow, Corvus brachyrhyncos. Can. J. Zool. 76: 508-512.
Wright, M.D., P. Goodman, and T.C. Cameron. 2010. Exploring behavioural responses of shorebirds to impulsive noise. Wildfowl. 60: 150–167.
Appendix A.1: Map of the Survey Area, Vantage Points for Observation of Active Night Roosts and Suggested Noise Monitoring Station
